Introduction

The production capacity, mining sequence and mining lifetime are the three significant factors in the optimization of open pit mine production scheduling. While production capacity is related to technical conditions of the mine, mining sequence is related to mine organization management, and mining lifetime is restricted by mine scheduling and industry norms; furthermore, these three factors are affected by geological conditions of the ore body, reserves scale, marketing environment and other elements1,2,3,4. In addition, compared with other external conditions, there is also interaction and influence among the three elements of production scheduling. For example, the more significant the production capacity is, the shorter the mining productive life. Different mining sequences (pit advancement position at the end of the year) directly affect the year's production capacity and then affect the overall mining life. In practice, therefore, optimized mining scheduling determines the annual estimated amount of mined ore, the annual estimated amount of stripped waste rock (i.e., production capacity), which areas are mined and stripped each year or how each step is advanced (i.e., the mining sequence), and the mining period (i.e., the mining lifetime).

Production scheduling provides a future production strategy for a mine (new mine or mine in producing). Moreover, for a given deposit, the quality of the production schedule has a significant impact on infrastructure investment and cash flow, which is distributed on the timeline after production. This influence becomes an important factor in the investment return rate of the whole mine project. That is why international mining companies have a strong interest in optimizing production scheduling. Production scheduling optimization is always a popular research topic in mine system engineering. From the perspective of optimization, the open pit mine production schedule determines the mining time of each module in the massive deposit model to determine which module should be mined each year to maximize the total NET present value and meet the space–time relationship and technical and economic constraints of open pit mining.

The "mining increment sorting method" is the earliest computer optimization method applied to production scheduling. It was first proposed by engineers of the Kennecott Company and applied in the company. The mining increment is generated by constructing cones, and cone structure, evaluation and sequencing are carried out via human–computer interaction trial and error5. Production increments for production scheduling can be obtained by the "parametric analysis" proposed by Lerchs and Grossmann6. This method is further developed into the "reserve parameterization" method, and many scholars have carried out further research on the solution of reserve parameterization and its application in production scheduling7,8,9,10,11,12.

One of the inherent defects of parameterization is the "notch" problem; in the generated limit sequence, the increments between some of the adjacent limits are so large that the limit sequence cannot be used for production scheduling optimization. Therefore, some researchers use heuristic algorithms to generate nested limit sequences to overcome the gap problem13,14,15,16,17,18,19,20 and dynamically order the resulting limit sequence18,21,22,23,24,25.

In summary, the essence of the production scheduling optimization problem is to determine the optimal production time of each module on the premise of meeting the necessary constraint conditions to obtain the maximum total NET present value. It is a typical linear programming problem. Therefore, linear programming (its specific form includes mixed programming, pure integer programming and 0–1 programming) is one of the most commonly used mathematical optimization methods to solve the optimization problem of production scheduling; related studies were carried out as early as the late 1960s 26,27. Many researchers have established linear programming models with different concrete forms for different aspects of production scheduling problems27,28,29,30,31,32,33,34,35.

However, the quantity of variables and constraint equations in the linear programming model for optimizing production scheduling is too enormous when a single module in the massive deposit model is used as the decision unit. That is a situation that even today's computers cannot solve directly; if it is integer programming, it can hardly be solved. Therefore, some researchers try to find solutions in the construction of mathematical model forms (mainly constraints) or solving algorithms (usually by feat of approximate algorithms) to boost the solving speed36,37,38,39,40,41,42. Increasing the decision-making unit to reduce the quantity of variables and constraints is a more common way, such as combining the modules in the deposit model into a "unit tree" as the decision unit in optimization or taking steps or panels as the decision unit37,43,44,45,46,47,48,49,50,51. However, due to the low scheduling accuracy (or resolution) in enormous decision units, the results are significantly different from the optimal plans, which also reduces the practicality of the results47,49,52,53. Therefore, many researchers make use of the unique structure of the mathematical model to reduce the model size with the Lagrange relaxation method and solve the model with other measures and algorithms, such as iteration, decomposition, gradient method, and the Dantzig network flow method54,55,56,57,58,59,60,61,62,63,64,65,66,67,68. The biggest obstacle to this approach is the "gap" problem. Researchers have tried various methods to solve this problem, but they have not sought out suitable means.

Open pit mine production scheduling is a typical multi-period decision-making problem; moreover, the time is interrelated so that dynamic programming can be used to solve it. Therefore, dynamic programming is also one of the most used mathematical optimization methods to solve the problem. Researchers have used dynamic programming to study the optimization of different aspects of production scheduling1,69,70,71,72,73,74,75,76,77,78,79,80,81,82,83,84.

Because of the insurmountable difficulties in applying mathematical optimization models to obtain the exact solution of production scheduling, some researchers turn to approximate algorithms, such as genetic algorithms, random, local search, particle swarm algorithms, and simulations, to obtain one or more "perfect" plans85,86,87,88,89,90,91,92,93,94,95,96,97.

In the process of production schedule optimization, in addition to exploring mathematical methods to solve the problem, another factor is to consider the specific influencing factors of the optimization process. In the study of the traditional optimization problem, first, it is assumed that a known factor could affect the optimization of the production schedule. For example, most studies determine the mine production capacity according to the Taloy formula, similar mine factors, or relevant experience and then optimize the mining sequence based on the determined production capacity. Finally, the relevant infrastructure is allocated according to the production scheduling98,99,100,101 set boundary grades in different periods with the maximum net present value as the objective function to ensure that the infrastructure meets the maximum comprehensive processing capacity of mining, beatification and smelting. This method can obtain higher economic benefits than the Lane method; nonetheless, the characteristic of uniform grade distribution is not applicable to most mines. On the side, the method described by Khan and Asad et al. focuses on the impact of geological uncertainty, marketing environment change and risk management on production scheduling83,101,102,103,104,105,106,107,108.

Consequently, due to the high complexity of production scheduling optimization and the difficulty of finding an exact solution, it is still a popular research topic. Many problems in the process of production scheduling optimization of open pit mines exist, such as low operation efficiency caused by large amount of calculation, disorderly expansion of production capacity caused by the scale effect, and difficulties in simultaneously optimizing the three elements due to the interaction relationship. In view of these problems, taking the maximum comprehensive net present value (NPV) as the objective function, the method of mobile capacity search domain is proposed to improve the operation efficiency, the infrastructure investment function based on the maximum production capacity is constructed to restrict the production capacity, the facility idle threshold is designed to reduce the fluctuation range of production capacity, and the enumeration method is used to evaluate all workable paths to realize the simultaneous optimization of the production capacity, mining sequence and mining life of open pit mines.

Mathematical model of discrete body dynamic programming

The purpose of production scheduling optimization of open pit mines is to determine how much ore and rock are extracted and stripped every year, where they are advanced and how long the mining life is. Therefore, the deposit should be divided into a finite number of discrete bodies, which should be taken as the alternative objects of open pit mining at the end of the year. Due to the characteristics of open pit mining technology and safety requirements, mining engineering needs to be carried out gradually from top to bottom in accordance with the specified slope angle, and the division of discrete bodies needs to meet the geometric space relationship. According to the definition and generation principle of the "geological optimal pit" proposed by1, a series of fully nested discrete bodies, namely, the "geological optimal pit sequence", can be obtained. The specific process for generating the "geological optimal pit sequence" is as follows:

Started from the bottom of the ultimate pit (also the first geological optimal pit), floating cone exclusion method is used to find out all the parts whose ore volume is equal to the given increment (such as 2 million tons), and among these parts, the one that holding the lowest average grade removed from the ultimate pit, leaving a pit that is 2 million tons less than the ultimate pit. The pit has the highest metal content of all the pits, with 2 million tons less ores than the ultimate pit. So the second geological optimal pit (the first is the ultimate pit) is obtained. Then, in the remaining pit (the second geological optimal pit), remove the part with the ore volume equal to the given increment (2 million tons) and the minimum average grade by the same method, and a smaller pit (the third geological optimal pit) is obtained. According to the method analogy, the ultimate pit is discretized into a series of completely nested discrete body sequences, that is to say, the geological optimal pit sequence.

The discrete bodies are put into the dynamic sorting model as state variables, as shown in Fig. 1.

Figure 1
figure 1

Discrete body dynamic sorting.

The circles in Fig. 1 represent a discrete body (geological optimal pit), which is also where the pit is advancing at the end of a year. The two circles linked by arrows, such as J1 in the first year and J3 in the second year, linked by dotted arrows, indicate that the open pit advances to J1 in the first year and J3 in the second year. In geometric space, J3 completely contains J1, therefore the quantity of ore corresponding to J1 and J3 can be expressed as O1,1 and O2,3, and the quantity of rock can be expressed as R1,1 and R2,3. In fact, since the quantities of ore and rock of each discrete body have been determined, O1,1 and O2,3 are equal to O1 and O3; R1,1 and R2,3 are the same as R1 and R3, mainly for the purpose of relating to time. Then, the quantity of ore and rock of the jth discrete body corresponding to the ith year can be expressed as Oi,j and Ri,j, respectively. Therefore, the quantity of ore oi−1, k (i, m) and rock produced from discrete body Jk in year i − 1 to discrete body Jm in year i where m > k, because the discrete body must be advanced from small to large, are ri−1,k (i, m), respectively:

$$o_{i - 1,k} \left( {i,m} \right) = \, ({\text{O}}_{{i - {1},k}} - {\text{O}}_{i,m} ) \times \gamma /\left( {{1} - \delta } \right)$$
(1)
$$r_{{i - {1},k}} \left( {i,m} \right) = \, \left( {{\text{R}}_{{i - {1},k}} - {\text{ R}}_{i,m} } \right) - o_{{i - {\text{1,k}}}} \left( {i,m} \right) \, \times \delta + \, \left( {{\text{O}}_{{i - {1},k}} - {\text{ O}}_{i,m} } \right) \times \left( {{1} - \gamma } \right)$$
(2)

where γ is the ore recovery rate and δ is the mixing rate of waste rock.

The concentrate amount vi-1,k(i, m), which transitions from the discrete body Jk in year i − 1 to the discrete body Jm in year i, is:

$$v_{i - 1,k} \left( {i,m} \right) = \left[ {\left( {O_{i - 1,k} \times g_{k} - \, O_{i,m} \times g_{m} } \right) \times \gamma + o_{i - 1,k} \left( {i,m} \right) \, \times \delta \times g_{r} } \right]/g_{v}$$
(3)

where gk and gm represent the average grade of ore in the kth and mth discrete bodies; gr represents the average grade of rock (Ri-1,k − Ri,m) transiting from discrete Jk to discrete Jm; gv refers to concentrate grade.

The profit ui − 1,k(i, m), which transitions from the discrete body Jk in year i − 1 to the discrete body Jm in year i, is:

$$u_{i - 1,k} \left( {i,m} \right) = v_{i - 1,k} \left( {i,m} \right) \, \times p_{v} \times \left( {1 + \eta } \right)^{i - 1} - \left[ {o_{i - 1,k} \left( {i,m} \right) \, \times \left( {c_{o} + c_{p} } \right) \, \times \left( {1 + \varepsilon } \right)^{i - 1} + r_{i - 1,k} \left( {i,m} \right) \, \times c_{r} \times \left( {1 + \varepsilon } \right)^{i - 1} } \right]$$
(4)

where pv refers to the price of concentrate, ¥/t; co, cp and cr represent mining cost, processing cost and stripping cost, respectively, ¥/t; and η and ε represent the price rise rate and cost rise rate, respectively.

The net present value NPVi-1,k (i, m), which transitions from the discrete body Jk in year i − 1 to the discrete body Jm in year i, is:

$${\text{NPV}}_{{i - {1},k}} \left( {i,m} \right) \, = u_{{i - {1},k}} \left( {i,m} \right)/\left( {{1} + \lambda } \right)^{i}$$
(5)

where λ represents the discount rate.

The transition process mentioned above is the transition process between different states. Without considering the constraints of production capacity, any year in Fig. 1 may be the final life of the mine. It is also the year in which the mine is mined to the final state JN (discrete body, which is also the ultimate pit of the open pit mine). In addition to the three production costs of mining, stripping and processing given in Eq. (4), another significant cost is infrastructure investment. It generally occurs at the initial stage of mine construction, i.e., the infrastructure investment does not affect the state transition shown in Fig. 1. However, it will affect the final economic benefit of the mine. Therefore, it is necessary to consider the infrastructure investment in each NPV that reaches the final state JN through different paths. Although infrastructure investment has no influence on a state transition, infrastructure investment is affected by mine production capacity, and mine infrastructure investment usually needs to meet the maximum production capacity in the whole life cycle of the mine. In other words, the infrastructure investment needs to meet the maximum ore quantity difference between any two adjacent time points in the state transition process on a path to the final state JN, as shown in Fig. 1; that is, the maximum production capacity on this path is max{oi-1,k(i, m)}. According to Eq. (1), the quantity of ore produced by state transition at two adjacent time points is oi-1,k(i, m). Therefore for a particular path L(D) with a mining life of D years, its maximum production capacity qL(D) is:

$$q_{L\left( D \right)} = \mathop {max}\limits_{{k \in \left[ {i - 1,m - 1} \right]}} \left\{ {{ }\left( {{\text{O}}_{i - 1,k} { } - {\text{ O}}_{i,m} { }} \right) \times {\upgamma }/\left( {1 - {\updelta }} \right){ }} \right\}$$
(6)

The infrastructure investment of the mine can be approximated as a linear function of the maximum production capacity of the ore. For the path L(D) with a mining life of D years, the infrastructure investment cL(D) can be approximated as:

$$c_{{{\text{L}}({\text{D}})}} = {\text{a}} + {\text{b}} \times q_{{{\text{L}}({\text{D}})}}$$
(7)

where a refers to the infrastructure investment base unrelated to the production scale, 104 ¥, and b refers to the infrastructure investment per unit of mining amount, ¥/t.

The comprehensive economic benefit NPVL(D) for path L(D) can be expressed by the following formula:

$${\text{ NPV}}_{{{\text{L}}\left( {\text{D}} \right)}} = c_{{{\text{L}}\left( {\text{D}} \right)}} + \mathop \sum \limits_{i = 1}^{D} {\text{NPV}}_{i - 1,k} \left( {i,{ }m} \right).$$
(8)

Enumeration optimization algorithm of production scheduling

Set a wide enough range of ore production capacity [qlow, qup], and the optimal production capacity must be within this range. This range is set by the user and is the input data. Let n represent the ordinal number of the constraint domain of ore production capacity, and [qLn, qUn] define the nth constraint domain (capacity search domain).

  • Step one: Set n = 1 and juxtapose the Bohr variable LastPlan = false. In the discrete body sequence {J}N, the discrete body whose ore quantity is greater than or equal to and closest to qlow is found, and its number is denoted as H.

  • Step two: Set the lower bounds qLn and upper bounds qUn of the constraint domain [qLn, qUn]:

    $$q_{{\text{L}}}^{n} = {\text{O}}_{{\text{H}}} {-}\Delta {\text{P}}/{2}$$
    (9)

    where ΔP is the ore increment of the pit set when the discrete body sequence {J}N is generated1, and OH is the ore quantity of the Hth discrete body in the sequence {J}N.

    (10)

    where ON is the total ore quantity in the ultimate pit and x1, x2, x3 are the search domain constraints, which are determined according to the size of the mine. If G > N obtained by Eq. (10), set G = N. The upper bound of the domain is

    $$q_{{\text{U}}}^{n} = {\text{O}}_{{\text{G}}} + \Delta {\text{P}}/{2}$$
    (11)

    where OG is the ore quantity of the Gth discrete body in sequence {J}N.

    If qUn > qup, LastPlan = true.

  • Step three: Find all production scheduling whose annual ore output meets the constraints of the domain [qLn, qUn]. That is, find all subsequences in which the annual ore output falls into the domain [qLn, qUn]. Calculate the NPV of each schedule, record the schedule with the highest NPV, and call the schedule the "local best schedule" in the domain [qLn, qUn]. The specific method is as follows:

    • Step 1: Set i = 1 (first year). A discrete body is found in the discrete body sequence {J}N. The ore quantity is no less than and closest to qLn, the lower limit of the constraint domain [qLn, qUn] of the set ore production capacity, and the total quantity of ore and rock is no more than qup of the set annual mining and stripping capacity. If such a discrete body is found, its number in {J}N is H(1); that is, the pit at the end of the first year on the planned path L under construction is advanced to pit JH(1)*. According to Eqs. (1), (3), calculate the quantities of produced ore o1, concentrate v1 and stripped waste rock r1 in this year. Then, calculate the annual profit u1 and its net present value NPV1 discounted to time 0 according to Eqs. (4), (5). Move on to the next step. If such a discrete body is not found, there is no workable schedule, and the algorithm terminates.

    • Step 2: set i = i + 1 (next year).

    • Step 3: The discrete body number H(i) is equal to H(i − 1) + 1 in year i, and H(i-1) is the discrete body number of the previous year of the planned path L under construction.

    • Step 4: According to Eqs. (1), (2), calculate the ore mining quantity oi and waste rock stripping quantity ri from i − 1 to i.

    • Step 5:

      1. (A)

        If oi < qLn and oi + ri ≤ qup.

      2. (B)

        H(i) = N, that is, the discrete body JH(i) is the last (ultimate pit) in the sequence {J}N, then the planned path L under construction has reached the end point, and the final state JN is the discrete body of the end point on the path. A complete workable planned path is obtained, and its mining life D = i. According to Eq. (3), the concentrate quantity vi in the first year is calculated, and then according to Eq. (45), the annual profit ui and its net present value NPVi discounted to time 0 are calculated. Go to step 6.

      3. (C)

        H (i) < N, the ore quantity of year i is lower than the lower limit of the set annual ore production capacity, which is not workable. Set the discrete body number H(i) to H(i) + 1, that is, consider a larger discrete body, and return to step 4.

      4. (D)

        qLn ≤ oiqUnand oi + ri ≤ qup.

        Discrete body JH(i) is the workable pit state at the end of i on the planned path L under construction. According to Eq. (3), the concentrated quantity vi of year i was calculated. Then, according to Eqs. (4), (5), the annual profit ui and its net present value NPVidiscounted to time 0 were calculated. If H(i) = N, then the planned path under construction has reached the final state, and a complete workable planned path has been obtained. Set the mining life of the intended path to D = i and carry out step 6. Otherwise, return to step 2.

      5. (E)

        If oi > qUn or oi + ri > qup.

        The quantity of ore mining or the total quantity of mining and stripping in year i exceeds the set upper limit, there is no workable plan, and the algorithm terminates.

    • Step 6: Thus far, a workable planned path with "minimum ore output" is obtained, that is, the quantity of ore extracted in each year of the path except the last year is just enough to meet the set minimum annual ore production capacity qLn. Calculate the infrastructure investment c L(D) of the shcedule according to Eqs. (6), (7). Calculate the total NPV L(D) of this path according to Eq. (8). Take the path as the current path and save it as the best path.

    • Step 7: Set time i = D − 1, where D is the mining life of the current path L.

    • Step 8: Build a new workable plan path starting from year i. The new path will be the same as the current path in year 1 to (i − 1). Add 1 to the current path's discrete body number of year i, that is, set H(i) = H(i) + 1.

    • Step 9: According to Eqs. (1), (2), calculate the ore quantity oi and waste rock quantity ri from i − 1 to i.

    • Step 10: Distinguish feasibility and economic evaluation, divided into two cases:

      1. (A)

        If oi< qUn and oi + ri ≤ qup.

        Discrete body JH(i) is the workable pit state at the end of year i of the new planned path being constructed, and it becomes the discrete body of last year i of the current path (that is, the original discrete body is replaced). According to Eq. (3), the concentrated quantity vi of year i is calculated. Then, according to Eqs. (4), (5), the annual profit ui and its net present value NPVidiscounted to time 0 are calculated. If H(i) = N, the new planned path under construction has reached the final state and a complete workable planned path has been obtained, and its mining life is D = I; go to step 15. Otherwise, go to step 11.

      2. (B)

        If oi > qUn or oi + ri > qup.

        If the quantity of ore mining or the total quantity of mining and stripping in year i exceeds the upper limit set, it is not workable. Set i = i − 1, that is, go back one year along the current path. If i > 0, go back to step 8. Otherwise, all workable plan paths are constructed and evaluated; proceed to step 16.

    • Step 11: Set i = i = i + 1.

    • Step 12: The discrete body number H(i) is equal to H(i − 1) + 1 in year i, where H(i-1) is the discrete body number of the previous year of the new planned path being constructed.

    • Step 13: According to Eqs. (1), (2), calculate the ore quantity oi and waste rock stripping quantity ri from i − 1 to i.

    • Step 14:

      1. (A)

        if oi< qLn and oi + ri ≤ qup, in two cases:

      2. (B)

        H(i) = N, that is, the discrete body JH(i) is the last (ultimate pit) in the sequence {J}N, the new planned path under construction has reached its endpoint, and the ultimate pit JN is the end discrete body on this path. Finally, a complete workable planned path is obtained, and its mining life D = i. According to Eq. (3), the concentrated quantity vi of year i was calculated, and then according to Eqs. (4), (5), the annual profit ui and its net present value NPVi discounted to time 0 were calculated. Perform step 15.

      3. (C)

        H(i) < N, the ore quantity of year i is below the lower limit of the set ore production capacity, which is not workable. Set discrete body number H(i) = H(i) + 1, that is, consider a larger mining discrete body, and return to step 13.

        If qLn ≤ oiqUn and oi + ri ≤ qup x.

        Discrete body JH(i) is the workable state at the end of year i on the new plan path under construction. According to Eq. (3), the concentrated quantity vi of year i was calculated, and then according to Eqs. (4), (5), the annual profit ui and its net present value NPVi discounted to time 0 were calculated. If H(i) = N, then the new planned path under construction has reached the final state, and a complete workable planned path has been obtained. Its mining life is D = i, and step 15 is carried out. Otherwise, return to step 11.

      4. (D)

        If oi > qUn or oi + ri > qup.

        The quantity of ore mining or the total quantity of mining and stripping in year i exceed the set upper limit, which is not workable. The algorithm gives up halfway and displays error information. Go to step 16 and output the best path thus far.

    • Step 15: After a new workable scheduling path is established, calculate the infrastructure investment cL(D) of the schedule according to Eqs. (6), (7). Calculate the total NPV L(D) of this path according to Eq. (8). If the total NPV L(D) of this path is greater than the total NPV L(D) of the saved best path, the path is reserved as the best path (that is, the original best path is replaced); otherwise, the original optimal path remains unchanged. Take this path as the current path and return to step 7.

    • Step 16: Output the best-planned path on the interval [qLn, qUn].

  • Step four: If LastPlan = false, go to the next step. Otherwise, if LastPlan = true, go to step six.

  • Step five: Set n = n + 1 and H = H + 1. Return to step two and set the next constraint domain, and continue the iteration. In this iteration process, every time H increases by 1, the lower bound qLn of the domain calculated according to Eq. (9) increases once. The whole domain also moves to a higher production capacity.

  • Step six: The constraint domain covers the entire range of ore production capacity [qlow, qup]. The best schedule is obtained by finding the one with the highest NPV among all the local best schedules recorded; Output the best schedule. The algorithm can also output all local best schedules to see how NPV varies with ore production capacity. The algorithm ends.

In the above algorithm, the larger the width of the constraint domain (qLn, qUn) is, the more schedules satisfy the constraint of (qLn, qUn). If the domain is set wide, the number of schedules to be evaluated in step three is too large and time-consuming. If the range is too narrow, the probability of missing the optimal schedule is high. The conditions listed in Eq. (10) in step two are to control the width of the constraint domain within such a range. In addition, for a given domain width, the number of schedules s satisfying the domain constraint increases rapidly with increasing mining life. The detailed algorithm flow is shown in Fig. 2.

Figure 2
figure 2

Flow chart of enumeration optimization algorithm for production scheduling.

Among the workable scheduled paths, the difference between some paths' total NPV and maximum total NPV is very small, which can be ignored. However, some paths may be more reasonable than those with the maximum total NPV, such as more stable ore yield and lower peel peak. Therefore, in the above algorithm, multiple optimal paths can be reserved and output for users to choose. When designing optimization software, the number of optimal paths to be reserved should be set by users as input data on the interface.

Case application

Basic introduction of mining area

The research takes the example of a large open pit iron mine in Luanzhou City, Hebei Province. The mine started construction in 2004 and reached production in 2009. The mining area has reserves of 2.3 billion tons with an average grade of 28.13% (Fig. 3). The details of this mine and the raw date for algorithm can be get in Supplementary Information.

Figure 3
figure 3

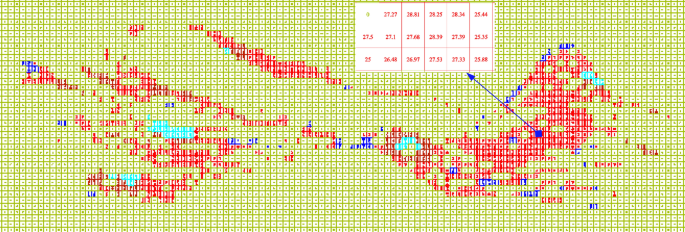

Grade distribution at − 172 m.

There are four orebodies distributed from east to the west in a parallel zonal arrangement. Figure 4 shows the section corresponding to exploration Line 12. The No. 1 ore-body is located in the east of the mining area, running through the three areas of north, central and south, with a total length of 8350 m and an average thickness of 60 m. The No. 2 ore body is located in the middle of the mining area, with a total length of approximately 900 m and an average thickness of 45 m. The ore body has a large extension depth, and the maximum control inclined depth has reached 680 m; this ore body is not seen on exploration Line 12. The No. 3 orebody is located in the middle and north of the mining area, with a total length of approximately 2800 m and a general thickness of 100 ~ 200 m; the deepest has reached 1600 m. The No. 4 orebody is distributed in the middle and north of the mining area, with a length of 1600 m.

Figure 4
figure 4

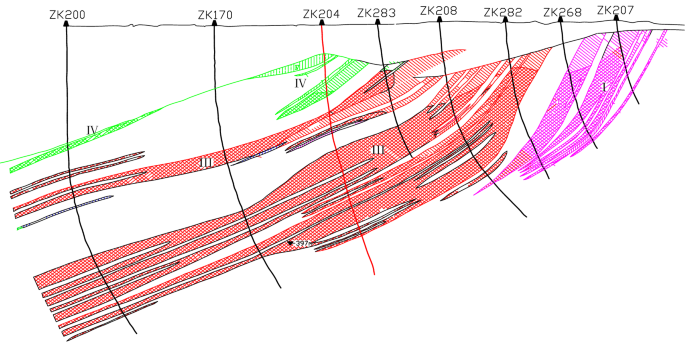

Section of exploration Line 12.

The mining status of the pit is shown in Fig. 5. The northern area has been mined to  − 67 m, and the southern area has been mined to  − 112 m. The unit weight of ore in the pit is 3.28 t/m3, the unit weight of rock is 2.7 t/m3, and the unit weight of topsoil is 2.0 t/m3. The height of benches above the 67 m level is 12 m, and below is 15 m. The slope angle of the bench is 65°, the width of the safety platform is 8 m, and the width of the working platform is 45 m.

Figure 5
figure 5

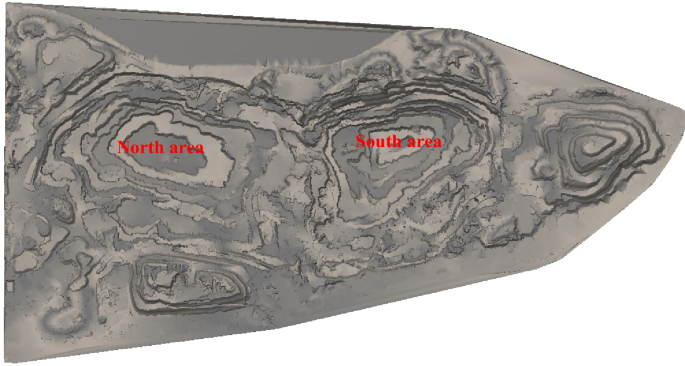

Mining status of pit.

Generation of discrete bodies

Based on the ultimate pit optimization algorithm constructed by Xu et al.109, the ultimate pit obtained is shown in Fig. 6. The quantities of ore and rock in the pit are 584.617 million tons and 2183.859 million tons, respectively. The minimum mining depths in the north and south are − 562 m and − 412 m, respectively. The pit covers an area of 435.99 × 104m2.

Figure 6
figure 6

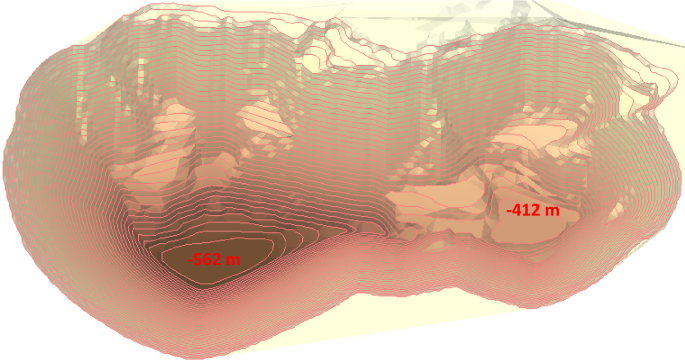

The ultimate pit of open pit mine.

First, a series of wholly nested discrete bodies1 is generated according to a working slope angle of 24°, an ore increment of two million tons, and a cutoff grade of 25%, as shown in Fig. 7. A total of 292 discrete bodies are generated.

Figure 7
figure 7

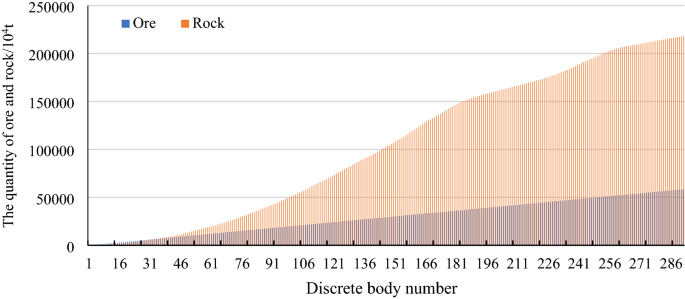

Discrete body sequence.

Optimization parameter design

The production scheduling optimization of open pit mines needs to determine parameters including economic parameters (mining cost, processing cost, stripping cost, concentrate price, infrastructure investment base, infrastructure investment of each ton of ores, discount rate, and cost and price increase rate), technical parameters (mining recovery rate, processing recovery rate, waste rock mixing rate, and cutoff grade), geological parameters (mixed waste rock grade, average grade, and concentrate grade), constraint parameters (production capacity range, maximum quantity of annual mining and stripping, infrastructure period, and pit closure period). Table 1 lists the specific parameter values.

Table 1 The value of production scheduling optimization.

Analysis of production scheduling optimization results

Based on the discrete body sequence shown in Fig. 7, combined with the relevant parameter settings in Table 1, the optimization algorithm constructed above is used to optimize production scheduling. In the optimization process, it is considered that the infrastructure project is built according to the maximum production capacity of the mine. However, if the production capacity fluctuates significantly in the production process of the mine, the equipment will be idle. Therefore, considering that the actual annual ore production is less than 90% of maximum capacity, idle costs will be incurred; idle costs for one year are 7% of the investment. In Eq. (10), the search domain constraint (x1, x2, x3) is (33, 20, 16), and the obtained optimization results are shown in Fig. 8.

Figure 8
figure 8

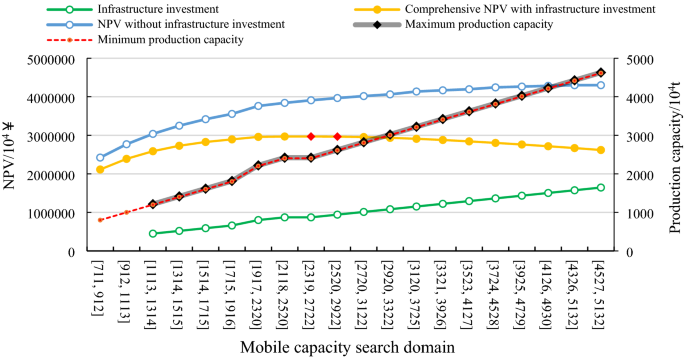

Results of optimal schemes in different capacity search domains.

According to Fig. 8, the horizontal coordinate represents the range of the mobile capacity search domain, that is, the production capacity constraint range. For example, [711, 912] indicate that the production capacity is constrained between 7.11 million tons and 9.12 million tons. The enumeration method can be used within this production capacity range to determine all workable paths (meeting the production capacity constraint) and calculate NPV. Meanwhile, the maximum production capacity corresponding to each path can be found to calculate infrastructure investment. Finally, the path of maximum NPV within this constraint is obtained. At the same time, this is the best production scheduling, including mining sequence, production capacity and mining life. Since the lower limit of production capacity is 8 million tons (generally speaking, if the ore reserves in the ultimate pit exceed 500 million tons, the production capacity will not be less than 10 million tons) and the upper limit is 50 million tons, the mining life of large open pit mines will not be less than 10 years. Therefore, there are 20 mobile search domains ranging from 7.11 million tons to 51.32 million tons, with a minimum width of 2 million tons (a whole increment) and a maximum width of 8 million tons (four increments).

Through dynamic sorting and production scheduling optimization of 292 state variables (discrete bodies), 20 search domains and 3 optimization elements, a total of 76.4 billion paths were searched, which took 5 h and 20 min. According to the traditional search method, if the optimization is conducted directly in the production capacity [800, 5000], the optimal solution is the same, but a total of 2000 billion paths are searched, which takes a month.

According to the blue line in Fig. 8, when infrastructure investment is not considered, the greater the mine production capacity is, the greater NPV will be due to the reasons of scale efficiency and time value of capital. Therefore, in these 20 search domains, the maximum value of the total NPV of the mine is generated in the search domain [4527, 5132], which is 43.001 ¥ billion, and the production capacity of the best production scheduling (excluding production capacity during infrastructure and pit closure) is within this range. Figure 9 shows the production scheduling corresponding to the maximum NPV, including the annual NPV (principal Y-axis), ore quantity, waste rock quantity, concentrate quantity (secondary Y-axis), mining life (principal X-axis) and annual pit advancing position (discrete body number, secondary X-axis). Among them, the maximum production capacity is 50.31 million tons. The stripping peak occurred in the 5th to 7th years (276.409 million tons, 287.141 million tons and 32.9222 million tons, respectively), and the spatial position of the pit showed discrete body numbers 125, 150 and 175, respectively. The mining life is 12 years.

Figure 9
figure 9

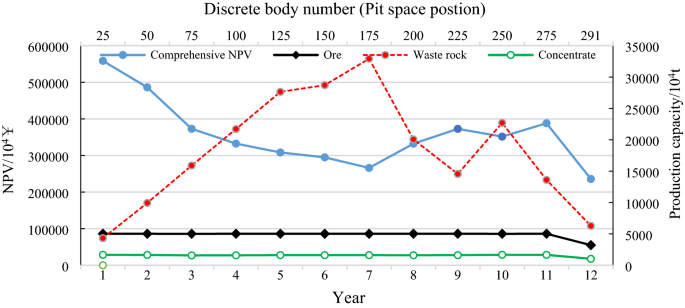

NPV maximum production scheduling without infrastructure investment.

When infrastructure investment is considered, since infrastructure investment positively correlates with production capacity, the greater the production capacity is, the greater the infrastructure investment. Therefore, with the increase in production capacity, the mine comprehensive NPV first increases and then decreases (as shown by the yellow line in Fig. 8). The maximum value of NPV occurs in the intersection area of search domains [2319, 2722] and [2520, 2922], which is 29.689 billion ¥. Figure 10 shows the production scheduling corresponding to this maximum NPV, including annual NPV (principal Y-axis), ore quantity, waste rock quantity, concentrate quantity (secondary Y-axis), mining life (principal X-axis), and annual pit advancing position (discrete body number, secondary X-axis). Furthermore, with a maximum production capacity of 24.2 million tons (infrastructure investment of 8.72 ¥ million) and a minimum production capacity of 24.04 million tons (excluding production capacity during infrastructure and pit closure), the peak of stripping occurred in the 9th to 15th years (120.447 million tons, 133.282 million tons, 138.258 million tons, 135.101 million tons, 153.425 million tons, 162.709 million tons and 147.378 million tons, respectively). The spatial position of the pit was shown as discrete body numbers 108, 120, 132, 144, 156, 168 and 180. The mining life is 25 years (Fig. 10).

Figure 10
figure 10

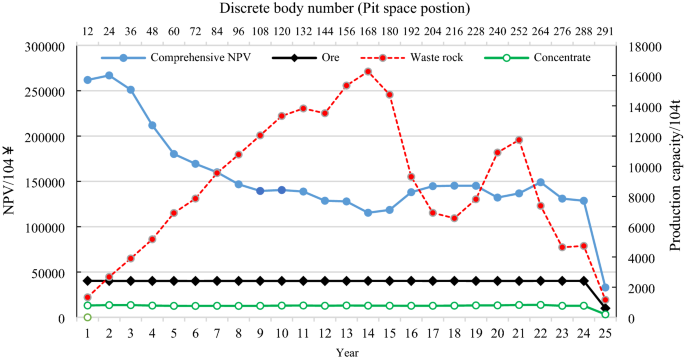

NPV maximum production scheduling with infrastructure investment.

Comparing Figs. 9 and 10, it can be seen that considering infrastructure investment in the optimization process of production scheduling has a great impact on mine production. The infinite expansion of production capacity is well constrained due to the consideration of infrastructure investment, and large quantities of rock stripping projects in the short term are balanced to avoid investment waste. The production capacity was reduced by 51.9%, the mining life was extended by 108.3%, and the mining sequence also changed greatly (for example, in the 5th year, the pit advancing position considering infrastructure investment is discrete body 60, while that not considering infrastructure investment is discrete body 125). The three-dimensional comparison of pit status in the 5th year is shown in Fig. 11.

Figure 11
figure 11

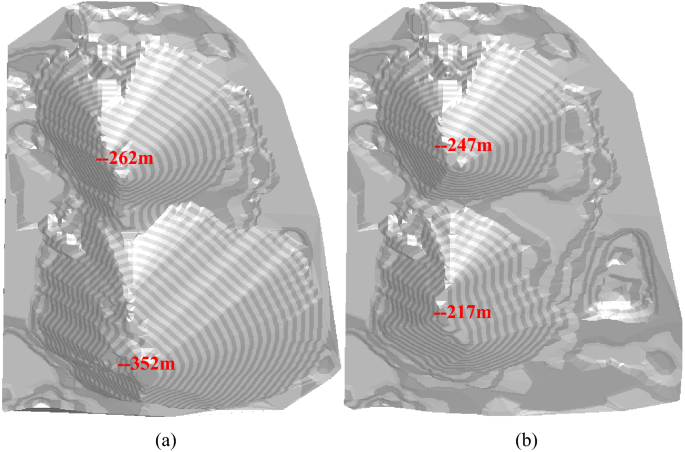

Pit status in the 5th year of the production scheduling with production capacity of 50.31 million tons (a) and 24.2 million tons (b) respectively.

As shown in Fig. 8, without infrastructure investment, the maximum production scheduling of NPV occurs in the intersection of search domains [4326, 5132] and [4527, 5132], which is 43.001 ¥ billion. The maximum production capacity of this scheduling in Fig. 9 is 50.31 million tons. According to Eq. (7) and parameter values in Table 1, it can be calculated that if the infrastructure is carried out following the scheduling, the infrastructure investment is 17.858 ¥ billion. Although infrastructure investment is not considered in the optimization process, infrastructure investment must be deducted according to the maximum production capacity of the optimal scheme. Therefore, the mine's final NPV is 25.142 ¥ billion. Under the condition of considering infrastructure investment, the maximum production scheduling of NPV (Fig. 10) occurs in the intersection area of search domains [2319, 2722] and [2520, 2922], which is 296.898 ¥ billion (Fig. 8). It can be seen that the overall economic benefit of the mine can be significantly increased by 18% when infrastructure investment is considered in the process of production scheduling optimization.

On one hand, if the production capacity of a mine fluctuates too much, it will increase the difficulty of management; on the other hand, it will also increase the cost investment. According to Fig. 8, the solid gray line and dotted red line corresponding to the subcoordinates represent the optimal production scheduling's maximum and minimum production capacity, respectively, in the corresponding search domain, regardless of the production capacity of infrastructure and pit closure. Moreover, it can be seen that the two lines almost overlap, and the fluctuation of production capacity of all optimal production scheduling in all search domains does not exceed 1.4%, which indicates that the "mobile capacity search domain" can not only ensure that the optimal production capacity is not omitted (the intersection part of two adjacent search domains) but can also effectively control the fluctuation of mine production capacity. Simultaneously, in the optimization process, the idle cost will be generated if the production capacity fluctuates greatly; therefore the disorderly expansion of production capacity will also play a constraint role in the process of economic optimization.

Conclusion

In view of the problems in the process of production scheduling optimization of open pit mines, such as low operation efficiency caused by a large amount of calculation, disorderly expansion of production capacity caused by the scale effect, and difficulties in optimizing the three elements at the same time due to the interaction relationship, taking the maximum comprehensive NPV as the objective function, the mobile capacity search domain method is proposed to improve the operation efficiency. Furthermore, the infrastructure investment function based on the maximum production capacity is constructed to restrict the production capacity, the facility idle threshold is designed to reduce the fluctuation range of production capacity, and the enumeration method is used to evaluate all workable paths to realize the simultaneous optimization of the production capacity, mining sequence and mining life of open pit mines. The results show the following:

  1. 1.

    The mobile capacity search domain method can intelligently calculate the optimization space according to the reserve scale and the lower limit of productivity and automatically design the capacity domain range, thus effectively reducing the number of search paths and improving the operation efficiency by 200 times. This method can significantly reduce the operation scale for open pit mines with a large number of discrete bodies, especially for the high-precision production scheduling design of large-scale open pit mines (the smaller the increment between discrete bodies is, the higher the precision), and has significant practical value.

  2. 2.

    In the process of production scheduling optimization, the consideration of infrastructure investment significantly influences production capacity, mining sequence and mining life. Infrastructure investment has effectively restrained the phenomenon of disorderly expansion of production capacity. Due to the scale effect, the life of mines has been prolonged by 1.1 times, which is more in line with mine production design specifications. In addition, considering the idle cost of infrastructure investment, the fluctuation range of production capacity is less than 1.4%. The peak of waste rock stripping is delayed for 4 years, and there is a relatively stable peak of waste rock stripping for 7 years, which balances large quantities of waste rock stripping projects in the short term and is convenient for mine management and cost savings.

  3. 3.

    When the infrastructure investment, which is set as a function of the maximum production capacity, is incorporated into the production scheduling optimization, the comprehensive NPV obtained is higher than that considered in the production scheduling optimization and infrastructure investment accounting. The scale effect of mines is only suitable for a certain range of production capacity. When the production capacity is small, with the increase in production capacity, the scale effect is reflected in reducing the unit production cost of the mine. When the production capacity reaches a certain level, due to the high infrastructure construction investment, the increase in unit cost is higher than the impact of the scale effect, which makes the overall economic benefits of the mine decline. The study shows that considering infrastructure investment in the process of production scheduling optimization can increase the overall economic benefit of the mine by 18%, which is very significant.

This study will continue to explore the functional relationship between mine production capacity and infrastructure investment. This paper is based on the data of multiple mines to synthesize a linear relationship, but the statistical samples are limited. From the perspective of economy and efficiency, infrastructure investment and production capacity are also contents that need to be optimized. At the same time, what needs to be further studied is the impact of different reserve sizes (the size of ultimate pit) on the overall economic benefits of the mine. This paper optimizes the production scheduling based on the given ultimate pit. For various ultimate pits, due to different ore and rock quantities, and spatial forms, the production scheduling will also be different, resulting in different economic benefits. What kind of reserve sizes and corresponding production scheduling are the best needs further scientific exploration.
